  • Advantages and disadvantages of Gantt charts

Advantages and disadvantages of Gantt charts

Gantt charts make task dates, overlaps and dependencies easier to see. Their main drawbacks are maintenance, clutter and estimates that look more certain than they are. They work best when your project has a meaningful deadline, dependent tasks and someone responsible for keeping the schedule current. The restaurant refit below shows where each benefit holds up, and where it falls apart.

A balance scale weighing a Gantt chart labelled clarity against a stack of update work labelled upkeep

Which Gantt chart advantages hold up, and when do they stop?

Each benefit depends on how the chart is built and maintained. Here are five to weigh up, followed by a restaurant refit with a fixed reopening date.

Advantage Holds while Stops being true when
Dates, order and duration in one view Someone updates the chart when work moves The last real update was weeks ago
Readable by people outside the team It shows the level of detail the reader cares about It has 200 rows of internal tasks
Shows the knock-on effect of a delay The tasks that block each other are linked Bars were placed by hand with no links between them
Exposes an impossible deadline early Durations come from the work Bars were squeezed until they fit the date you were given
Shows what can run in parallel Overlapping work belongs to different people One person owns three of the overlapping bars

One view of the plan, until the updates stop

Start, finish, duration and sequence sit in one picture, so you can answer "what happens in week six?" without piecing together a task list, calendar and someone's memory.

Say the kitchen equipment is due at the end of week 7, ready for the gas engineer in week 8. The supplier moves delivery to week 9 in a phone call nobody records, and the engineer is still booked for week 8 to commission an oven that is not there yet. The stale chart did more than miss the change: it handed the engineer the wrong date.

Readable by outsiders, until it grows to 200 rows

Owners, landlords and lenders can usually follow a short timeline with little explanation. Show five or six phases and the handful of dates they plan around; explain any unfamiliar symbols.

It stops holding as the chart fills up with the working detail that the people doing the job need, such as "order grease trap" or "book skip for the strip-out". At 200 rows the reader cannot find the three dates they care about. The fix is a view built for them, not a different kind of chart, and there is a good method for presenting a timeline to clients without sending them the working version.

Knock-on effects, but only when the tasks are linked

Dependency links let scheduling software work out what moves when a task slips. A static spreadsheet chart can show the same sequence, but it needs formulas or manual changes to update the dates. Drawing the bars alone does not automate the plan.

In the refit, landlord consent, the kitchen build, equipment installation and staff training form a chain with no spare time. If consent arrives a week late, the forecast reopening moves a week too. With the tasks linked and Auto schedule turned on, that effect is visible while there is still time to contact guests booked for opening night.

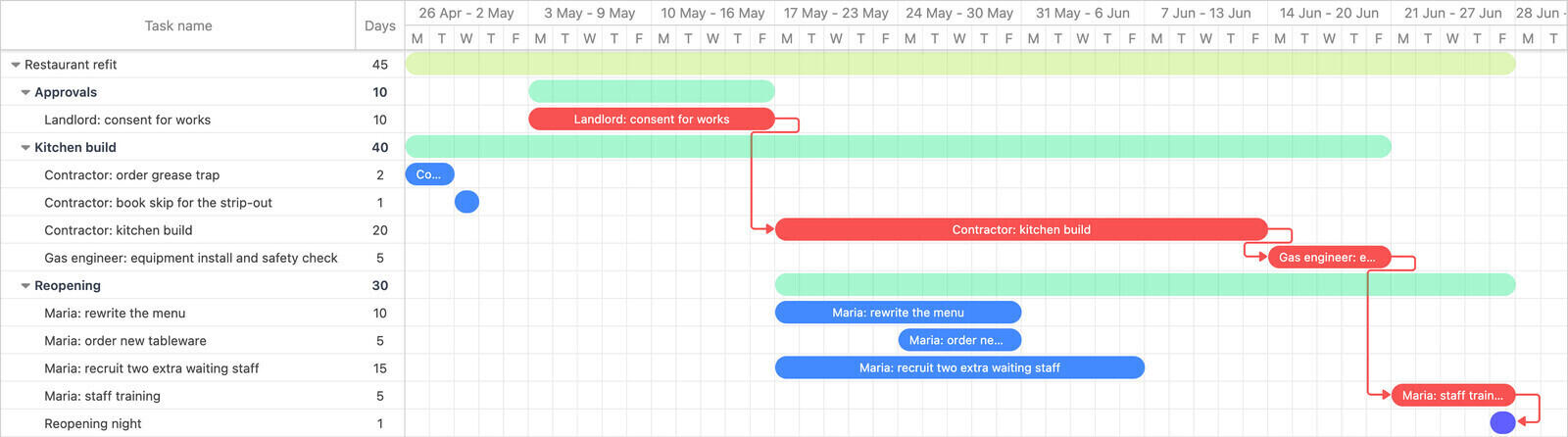

A restaurant refit Gantt chart after a one-week slip in landlord consent, with the linked kitchen build, equipment install and staff training highlighted as the critical path to reopening night at the end of week nine

In Ganttile, with Auto schedule turned on, linked tasks shift when a date moves, which keeps this advantage alive with no recalculating. It still pays to be selective about which tasks get linked, because linking tasks that only tend to happen in that order makes every small change ripple further than it should. The guide on which tasks to link covers where to draw the line.

It exposes an impossible deadline, unless estimates were squeezed to fit

Laying the work out end to end is where an impossible date usually reveals itself. If the landlord's consent takes two weeks, the kitchen build four, equipment install and the gas safety check one, and staff training one, the chain is eight weeks long. If reopening night is six weeks away, the chart has told you something important before anyone has taken a booking for it.

The condition is that the durations come from the work. When a plan starts from the deadline and the bars are shortened until they fit, the chart has the look of a plan and none of its information. A four-week kitchen build drawn as two weeks because that is what was left over is the deadline restated as bars, and it tells nobody when the kitchen will actually be ready.

Parallel work is visible; capacity needs checking

Overlapping bars show what can happen at the same time, and running work in parallel is usually where time is won back. In the refit, rewriting the menu, ordering new tableware and recruiting two extra waiting staff can all overlap with the kitchen build.

Bar length alone does not show capacity. If all three tasks belong to the general manager, check whether they can fit into the same week. Some tools have assignment and workload views; in Ganttile, put the owner at the front of the task name, as in "Maria: rewrite the menu", then check overlaps. The guide on evening out workload covers what to move first.

The main disadvantages of Gantt charts

The main drawbacks are upkeep, false precision, limited information in the bars themselves and a poor fit for some ongoing work. Software reduces the redrawing, but someone still has to check what has changed.

Upkeep is the price of admission

A Gantt chart is a commitment to update it whenever reality changes. The cost grows with two things: how many rows the chart has and how often the work moves. Fifteen rows on a stable project take a few minutes a week. A hundred and fifty rows on a project whose scope shifts every week take a real chunk of someone's time, and in a busy week the update is the first thing to be dropped.

Give the updates a named owner. Without one, changes can go unrecorded while the old dates keep circulating. If that has already happened, start with the symptoms in common chart mistakes.

Crisp bars make guesses look like facts

A bar ends on a specific day, and that precision is visual rather than real. A kitchen build estimated at "four weeks, maybe six if the extraction contractor is slow" becomes a bar that ends on a Friday, and by the third meeting everyone remembers the Friday.

This sits on top of a well-documented bias. Research on the planning fallacy finds that people underestimate how long their own tasks will take, even when similar tasks ran late in the past. An academic critique of the format, Geraldi and Lechter's review in the International Journal of Managing Projects in Business, makes the related point that the Gantt chart does not explicitly address complexity, ambiguity, uncertainty or change. It suits work that can be laid out in advance and strains on work that cannot.

The practical response is to keep the uncertainty visible on the chart. Give the uncertain task its realistic length rather than the hoped-for one, or put one shared buffer before the milestone that matters. There is more on estimating durations realistically if your dates keep proving optimistic.

A bar shows time, not effort or cost

"Legal review, 10 days" might be three hours of a solicitor's time spread over a fortnight of waiting. "Kitchen build, 10 days" might be a crew of four working full days. On a Gantt chart they are the same bar.

The bars alone cannot tell you whether the project is affordable or the team is overloaded. Those questions need cost, effort and capacity information. Some scheduling tools include it; in Ganttile, keep the budget and capacity checks alongside the schedule.

Ongoing work may fit a board better

Support queues and routine maintenance usually need a way to choose the next task, rather than a finish date for the whole stream. A board is often easier to maintain. Individual campaigns or maintenance projects can still benefit from a chart; the comparison of a Gantt chart and a Kanban board helps draw that boundary.

Should this project get a Gantt chart?

Use one when the project has a date with consequences, several tasks that block each other on the way to it, and someone who will own the updates. Skip it when the work is continuous, when one person can hold the whole thing in their head, or when the plan will be rewritten before the work starts. If you are unsure what the format involves, the basics of a Gantt chart are a quicker starting point than this decision.

Use one when

  • Missing the end date has a real cost, such as a lease ending, an event, a contract or a launch.
  • Some tasks genuinely cannot start until others finish, and a slip early on would move the end.
  • People outside the team need to know when things happen.
  • One named person will spend a few minutes a week keeping it true.

Skip it when

  • The work is a stream with no finish line.
  • It is a handful of tasks that can happen in any order.
  • The scope is still being discovered and the plan would be rewritten weekly.
  • The question you actually need answered is about budget or workload, not dates.

Three projects, three answers

The restaurant refit gets a chart without hesitation: a reopening date with bookings against it, a chain of dependent tasks, contractors and a landlord who need dates, and a general manager who can own it.

A monthly customer newsletter does not. It repeats, every issue follows the same few steps, and a checklist with a due date does the job with none of the upkeep.

Moving a ten-person company's email to a new provider sits in between. New mailboxes must exist before the domain switches, and staff need the switchover date, but there are only six or seven steps. A short chart with a few links and a switchover milestone may be enough. The steps for building your first chart pick up from here.

A lesson from the original charts

Wallace Clark's 1922 book The Gantt chart, a working tool of management emphasised comparing work planned with work done. That remains useful: save the agreed schedule as a baseline before changing dates, or the original promise disappears. The history of the chart covers how the format developed.

Other questions people ask

Are Gantt charts outdated?
No. The format is more than a century old, but the question it answers, what happens when, has not gone away. What changed is that software now moves linked tasks when a date changes, which removed most of the manual redrawing that used to make charts hard to keep.
Do Gantt charts work for remote teams?
Yes. They give remote teams a shared reference for dates and dependencies. Agree who maintains the schedule and how changes reach the team. In Ganttile, teammates you invite through its linked Breeze account can view and edit the same chart for free, and a dated PDF or image covers people outside the team.
Is a PERT chart better than a Gantt chart?
They answer different questions. A Gantt chart puts tasks on a calendar, while a PERT chart draws the logic between tasks as a network and is usually paired with estimates that allow for uncertainty. Most small teams get the useful part of both from a Gantt chart with dependencies and a critical path, and the two charts side by side show where each one helps.

Test it on your own project

A useful chart earns its upkeep by revealing something you need to act on: a late forecast, a dependency or a clash in someone's week. Keep only the detail that helps those decisions.

Try your schedule: Open the simple Gantt chart template, replace the sample tasks and durations, and link the work that must happen in sequence. Compare the forecast finish with your deadline before making a promise.
