9 Gantt chart mistakes and how to fix them

The most common Gantt chart mistakes are too much detail, unnecessary links, outdated dates and estimates squeezed to hide a delay. Missing owners, milestones and calendar checks make the problem worse. Use the symptom table to find your starting point, then make the chart true, smaller and easier to read.

An eraser rubbing out a tangle of over-linked task bars, leaving a few clearly linked bars and a milestone

How do you tell which mistake your chart has?

Start with what you notice. The examples follow an agency producing a spring product catalogue, from photography and copywriting through layout, proofs, printing and delivery.

What you notice Usually caused by
The weekly update takes longer than some of the tasks Too much detail
Any small change moves the end date Linking everything
People scroll past other work to find their own Several projects in one chart
Finished tasks look open and unstarted work sits in the past The chart is never updated
The deadline never moves, but the remaining bars keep getting shorter Dates squeezed to hide a delay
Tasks finish on the chart a day or two before they finish in reality Ignoring weekends and holidays
Status meetings open with "who has this?" No owners
Nobody can say if the project is on track without reading every bar No milestones
The client looks at the chart and asks when they get it Sending the client the working chart

Why is the chart such hard work to maintain?

Too many rows, unnecessary links and unrelated projects can make updates harder than they need to be. Fixing those problems lowers the effort of keeping the dates current.

1. Too much detail

Symptom: the chart runs to several screens, plenty of bars are a day long, and "email printer for quote" sits in the same list as "photograph 40 products". The weekly update takes longer than some of the tasks it records.

Why it happens: the chart doubled as a to-do list. Every item anyone thought of became a row, and rows are quick to add and slow to keep accurate.

Fix: group small actions into work you can own, estimate and track. Detail the next few weeks; expand later phases when you know more. The GAO schedule guide describes this as rolling wave planning. Keep "email printer for quote" in a checklist unless it represents a handoff that controls other work.

2. Linking everything

Symptom: nearly every task has an arrow from the one above it, and moving any single date, however minor, pushes the print date.

Why it happens: linking feels thorough, it takes one click, and templates often arrive with a chain already drawn.

Fix: ask why each link exists. In the catalogue, copywriting need not wait for photography unless the copy depends on the photos. But do not remove a link merely because both tasks have the same owner: it may represent limited capacity. Keep those scheduling decisions explicit and check workload after changing them. See which dependency links to keep.

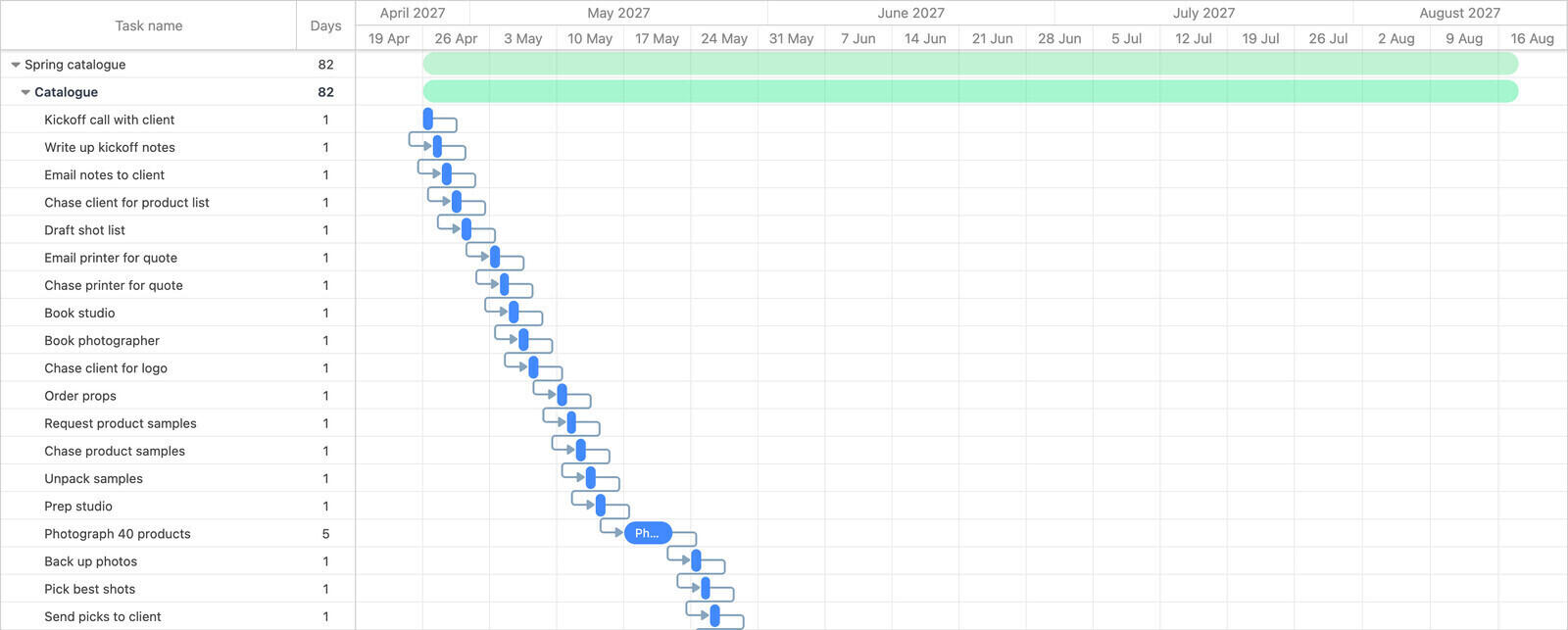

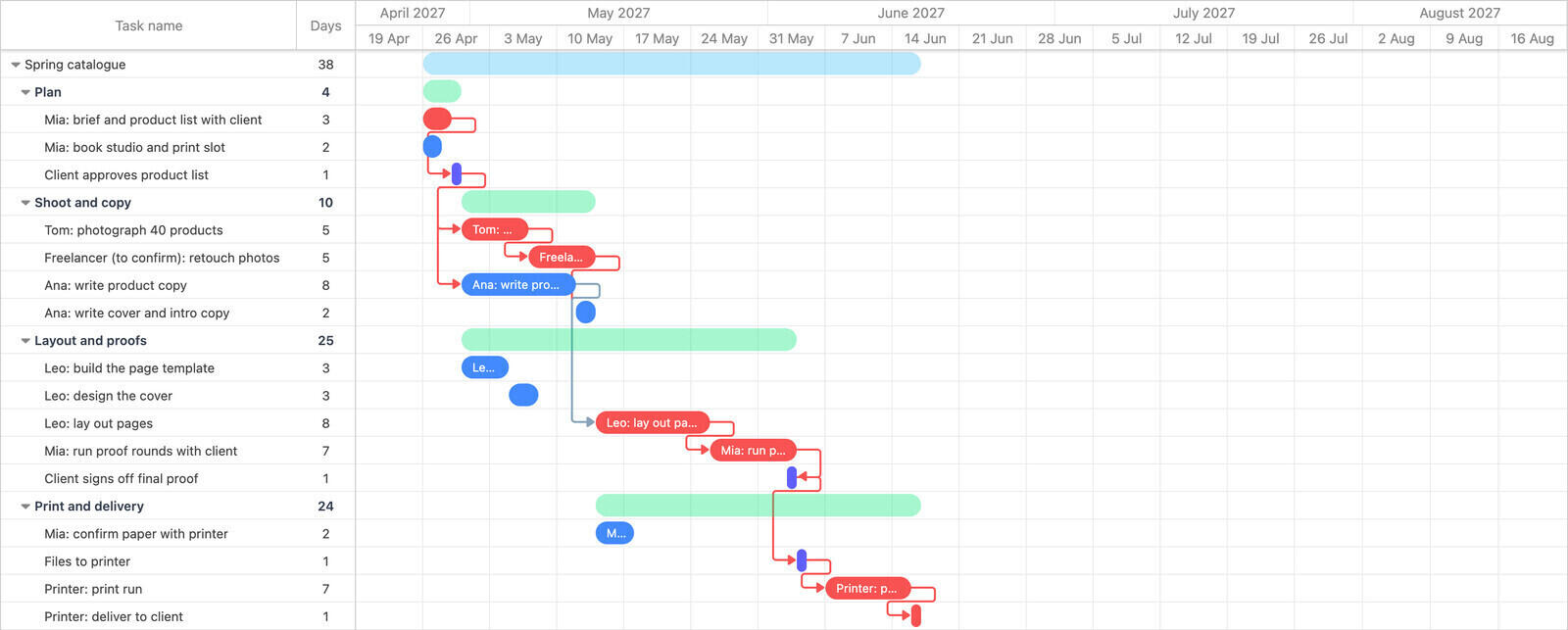

Before: a catalogue project Gantt chart with dozens of one-day tasks in one list, each linked to the task above it in a long diagonal staircase, with no phases or milestones After: the same catalogue project as four phases with thirteen owned tasks and three milestones, photography and copywriting running in parallel, and links only where work really waits

The pair above is the same project before and after these two fixes, counted in working days with Hide weekends on. The after version has under a third of the rows, and its forecast finish moves from day 82 to day 38. Most of that comes from removing the chained one-day admin rows, and the rest from running photography and copywriting in parallel. Neither task got shorter.

3. Several projects in one chart

Symptom: phases are named after clients, the chart is well past a hundred rows, and the catalogue client's timeline cannot be exported without showing two other clients' work.

Why it happens: the first project was in the file, so the second and third went in too because it was already open.

Fix: for this agency, keep a separate working chart for each client. Ganttile supports multiple projects. An integrated programme schedule can be appropriate when projects depend on one another; use a deliberate combined view for that job. See seeing several projects together.

Why does nobody trust the dates?

People stop trusting a chart when its dates have stopped matching what is happening, and there are three common ways that happens: nobody updates it, someone updates it to look better than it is, or the chart counts days differently from the team. Any one of them is enough for people to start keeping their own private list, at which point the chart is decoration.

4. Never updated

Symptom: tasks finished weeks ago still look open, work that has not started yet sits on dates that have already passed, and the team runs off its own notes.

Why it happens: updating the chart was nobody's named job. And once a chart is wrong, people stop looking at it, so nobody notices how wrong it has become.

Fix: give updates an owner and a regular slot. Mark completed work done, revise the remaining durations and dates, then check the resulting finish. Auto schedule can move linked tasks for you, but it cannot know what happened on the job. The GAO guide warns that unfinished work left in the past makes the schedule unrealistic.

5. Squeezing dates to hide a delay

Symptom: the print date has not moved in two months, but every update shortens the work still to come. Layout went from three weeks to two, and proofing from a week to three days, without anything about the work changing.

Why it happens: the end date was promised, moving it means an awkward conversation, and squeezing the remaining bars puts that conversation off for one more week.

Fix: give the remaining tasks the time they need and show the gap between forecast and deadline. Keep a separate deadline marker so it is not mistaken for the forecast finish. Once the gap is visible, consider scope, capacity or a revised commitment; handling a slipping task covers those choices.

6. Ignoring weekends and holidays

Symptom: a three-day task that starts on the Friday before a bank holiday weekend ends on the chart on the Sunday, though a team taking Monday off will not finish until Wednesday. Every public holiday adds a day or two of drift like this, and the week the printer closes for Easter shows a full week of printing.

Why it happens: the chart counts calendar days while the team thinks in working days, and no default calendar knows your holidays, your team's leave or a supplier's shutdown. The GAO guide calls relying on the software's default calendar a common mistake, because it rarely has national holidays defined.

Fix: agree whether estimates mean working or calendar days. In Ganttile, Hide weekends makes durations count working days. Check holidays, leave and supplier shutdowns separately; the setting does not know about them. Shift starts or allow for closures in the elapsed schedule without treating the extra days as extra effort.

What stops other people reading it?

A chart can be accurate and lean and still fail the people who did not build it. Three gaps cause most of that: no names on the work, no landmarks to measure progress against, and a client being sent a chart that was built for the team.

7. No owners

Symptom: the first ten minutes of each status meeting is "who has this?", and some tasks sit untouched because everyone assumed someone else had them.

Why it happens: one person built the chart from a scope list, so it describes the work but not the people doing it.

Fix: give each task one accountable owner, even if several people contribute. Ganttile has no assignment field, so use a prefix such as "Ana: write product copy". If the owner is still unknown, make that visible: "Freelancer (to confirm): retouch photos".

8. No milestones

Symptom: nobody can say whether the project is on track without reading every bar, and status updates are lists of tasks rather than "we will make the proof date".

Why it happens: milestones have no duration and do no work, so they can look like decoration.

Fix: start with a start and a finish milestone, which the GAO guide says every schedule should have, then add one for each decision or handoff people plan around. For the catalogue that is the client approving the product list, the client signing off the final proof, and files going to the printer. Link each milestone to the task that unblocks it so it moves when that task slips. The guide to how milestones and links work together covers placing them.

9. Sending the client the working chart

Symptom: the client looks at the chart and asks "so when do we get it?", or picks out an internal task and asks why retouching takes five days.

Why it happens: the working chart was sent because it was the only one that existed.

Fix: send a trimmed version. The client needs the phases, the dates they have to act on, such as proof reviews, and the delivery date. In Ganttile, tasks grouped into lists show as summary bars, so the phases carry the shape of the project, and you can export a PDF or an image to send instead of the working file. There is more on what clients want from a timeline, and if the client has never read a Gantt chart before, a short walkthrough of reading one saves a call.

Which fix should you make first?

Make the chart true first, then smaller, then readable. Restructuring a chart whose dates are wrong produces a tidier wrong chart, and a client view built from it passes the error along.

  • True: update it to what has actually happened, stop squeezing the remaining work, and fix the working-day setting. This is the step that tells you the real end date.
  • Smaller: cut the detail, remove the links that are not real blocks, and split out other projects. This lowers the upkeep that caused the chart to go stale.
  • Readable: add owners and milestones, then build the client version last, because it is derived from everything above.

For most charts the first two steps fit in one sitting. The new end date that comes out of the first step is often the most useful thing the chart has said in weeks, even when it is not welcome.

Before you start fixing

Should I fix my chart or start again?
Fix it if the task list still describes the work, even roughly. Start again when the scope has changed so much that most rows describe work you are no longer doing, because editing a plan for a different project takes longer than writing the right one.
Can a template cause these mistakes?
Yes. A template's durations and links were set for a typical project, not yours, so it can bring in over-linking or unrealistic durations from day one. Keep its structure, then check every link and duration against your own work before you share any dates.
Is it a mistake to use a Gantt chart in an agile team?
No. A release chart can help coordinate deadlines and work across teams. Problems arise when it duplicates a changing backlog or treats forecasts as fixed promises. See where a chart fits in agile.

Fix the problem that costs you most

Whichever symptom brought you here, check the dates against the work before you touch the layout, because no amount of tidying rescues dates that have stopped matching it. If the project never needed a chart, revisit whether a Gantt chart is worth keeping.

Repair your plan: Choose one symptom above and apply its fix. If you need a cleaner starting point, open the simple Gantt chart template and transfer only the tasks, dependencies and milestones your team needs.
